Monthly Archives: February 2020

Challenging what I know about Agile

I have been working in agile ways for many years now and many things have become a mantra for every new engagement: we have teams of 7 +/- 2 people, doing 2 weeks sprints and keep the teams persistent for the duration of the engagement. Sounds right, doesn’t it? But is it?

How do we know those things? Do we have science or do we just believe it based on the Agile books we have read and what people have told us? Over the last few weeks and months I have actively sought out differing opinions and research to challenge my thinking. I want to share some of this with you.

Team size

Agile teams are 5-9 people. Full stop. Right? There is some research from Rally from a while back that shows that smaller teams are having higher productivity and throughput than larger teams. Larger teams however have higher quality. So far so non-controversial. If quality is really important we want slightly larger teams and a higher percentage of quality focused people in the team. What really made me rethink was an interview that I heard with an Agile coach, where he described how having larger teams lead to better predictability of outcome. He made two arguments for that, one was quality as discussed above where lower quality leads to rework and in small teams that can really hurt predictability. The second one was the more obvious one, in small teams sickness, holidays or other events have a much larger impact and/or people might feel less able to take time off and burn-out. So with all this in mind perhaps slightly larger teams are overall better, they might be less productive but provide higher quality, are more predictable and more sustainable. Perhaps those qualities are worth the trade-off?

Persistent teams

Teams should be long-lasting so that they only have to run through the Forming-Storming-Norming-Performing cycle once and then they are good to go. Every change to the team is a disruption that causes a performance dip. So far the common wisdom. I have heard arguments for a change in thinking – the real game changer is dedication to a team. Being 100% assigned to one team at a time is more important than having teams that work together for a long period of time. Rally in their research found that dedicated people have a 2x factor of performance while long-standing teams have only 1.5x. This model will also allow for more flexibility with scarce skillset – people with those can dedicate themselves to a new team each sprint. I feel there is something that speaks for this argument but personally there is a probably a balance to be found between full persistency and frequent change, but at least we don’t have to feel bad when the context requires us to change the team setup.

Sprint/Iteration Length

Shorter sprints are better. 2 weeks sprint are the norm. I have said those sentences many many times. When I looked at the rally research it showed similar to team size that shorter sprints are more productive but longer sprints have higher quality. So we need to consider this in designing the length of the sprints. We also need to consider the maturity of technology and our transaction cost to determine the right sprint length (less automation = longer sprints). And then I heard an interview with a German start-up. They run 2 week sprints most of the time, but then introduce longer 4-6 weeks sprints sometimes and the reason they give is that 2 weeks is too short for real innovation. Dang. Have we not all felt that the tyranny of the 2 week sprints makes it sometimes hard to achieve something bigger, when we forcefully broke up stories to fit into the 2 weeks or struggled to get software releasable in the 2 week sprint. I still think that the consistency of the 2 weeks sprints makes many things easier and more plan-able (or perhaps it’s my German sense for order 😉). But at least I will think more consciously about sprint length from now on.

There you have it, three things I took for granted have been challenged and I am more open minded about these now. As always if you know of more sources where I can learn more, please point me to it. I will keep a much more open mind about these three dimensions of setting up teams and will consider alternative options going forward.

Segregation of Duties in a DevOps world

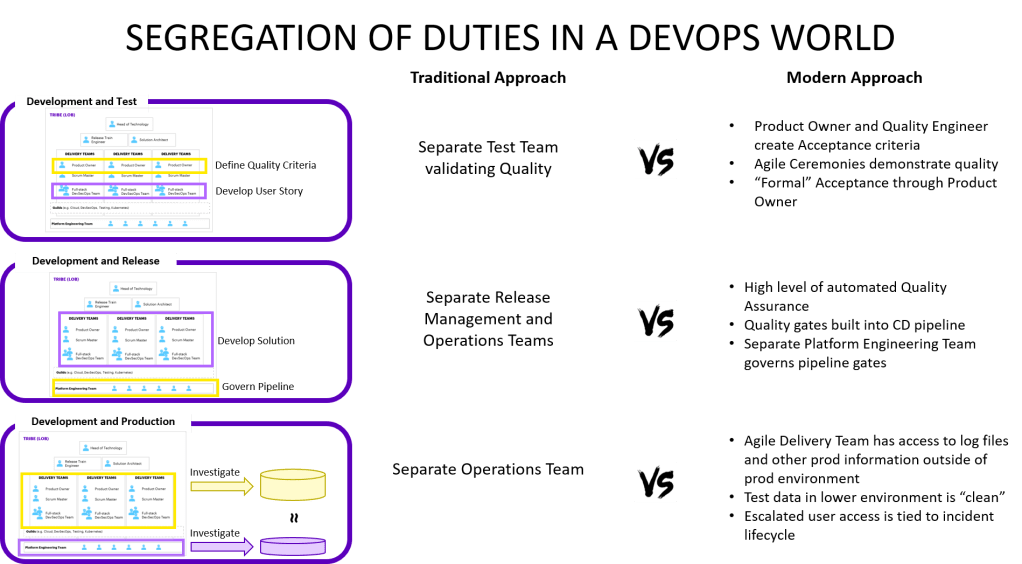

This scene could be from a spy movie: Two people enter the room where release management is coordinated for a major release. The person from the operations team takes out a folded piece of paper, looks at it and types half of the password on the keyboard. Then the person from the development team does the same for the second half and then deployment to production begins. A couple of years ago I was working for a client, where the dev and ops teams had half the password each for production. It was probably the most severe segregation of duties setup I have experienced. The topic of segregation of duties comes up frequently when organisations moving towards using DevOps ways of working. After all how can you have segregation of duties when you are breaking down all the barriers and silos?!?

Let’s explore this together in this post, but first let’s acknowledge a few things: First and foremost, I am not an auditor or lawyer. The approaches below have been accepted to different degrees by organisations I have worked with. Secondly; there are several concerns related to segregation of duties. I will cover the three most common ones that I have encountered and hopefully the principles still can be applied to further aspects accordingly. Let’s dive in!

Segregation of Development and Test

Problem statement: In a cross-functional team wouldn’t the developer “mark his own homework” if testing is done by the same team?!? To avoid this in the traditional waterfall world, a separate testing team performs an “objective” quality control.

Resolution approach: Even in a DevOps or Agile delivery team, more than one person is involved in defining, developing and testing a piece of work. The product owner or her delegate helps define the acceptance criteria. A developer writes the code to fulfill those and a quality engineer writes test automation code to validate the acceptance criteria. Additionally, team members with specific skills like penetration testing or UX test the work as well. And often business users perform additional testing. Agile ceremonies like the sprint demo and the acceptance by the product owner create additional scrutiny by someone other than the developer. In summary, segregation of duties between Dev and Test is achieved as long as people are working well across the team.

Segregation of Development and Release

Problem Statement: A developer should not be able to release software into production without independent quality check to make sure no low quality or malicious software can be deployed. Traditional approaches have the operations or release management team validate quality through inspection and governance.

Resolution approach: In a DevOps world, the teams should be able to deploy to production automatically without any intervention by another team. This is true whether we use traditional continuous delivery or more modern cloud native deployment mechanisms. But how can we create segregation of duties in those release scenarios? We leverage high levels of automated quality controls in modern release mechanisms, which means functionality, security, performance and other aspects of the software are assessed automatically before software is deployed and we can leverage this to create independent assurance. A separate group like a “Platform Engineering” team governs the quality gates of the release mechanisms, the standards for it and the access to it. This team functions as the independent assurance and all changes to the release pipeline are audited. The art here is to get the balance right so that the teams can work independently without relying on the Platform Engineering team for day-to-day changes to the quality gates, while still making sure that the quality gates are effective.

Segregation of Development and Production

Problem Statement: A developer should not be able to make changes to production or see confidential data from production, while a production engineer shouldn’t be able to use his knowledge of production to deploy malicious code that can cause harm. Traditionally access to production and non-production systems are only given to mutually exclusive development and operations teams.

Resolution approach: This is the most complicated of the three scenarios as people should get the best possible data to resolve issues, yet we want to avoid proliferation of confidential data that can lead to exploitation of such data. The mechanisms here are very contextual but the principles are similar across organisations. Give the developers access to “clean” data and logs through a mechanism that masks data. When the masked data is insufficient for analysis and resolution, then escalated access should be provided based on the incident that needs to be resolved. Automated access systems can tie the temporary access escalation to the ticket and remove it automatically once the ticket is resolved. This of course requires good hygiene of tickets as tickets which are open for a long time can create extended periods of escalated access. Contextual analysis is required to identify the exact mechanisms here, but in most organisations masked data should be able to cover most scenarios so that access to confidential data should be very limited. Root access to production systems should be very limited in any case as automation takes over traditional tasks that used to require such access hence the risk is more limited in a DevOps world. And automation also increase the auditability of changes as everything gets logged.

Summary of Segregation of Duties in a DevOps world

Hopefully this gives you a few ideas on how to approach segregation of duties in the DevOps world. Keep in mind that you achieve the best results by bringing the auditors and governance stakeholders to the table early and explore how to make their life better with these approaches as well. This should be a win-win situation, and in my experience it usually is, once you get to the bottom of what is actually the concern to address.
